Transgenia's Claude.ai Implementation Methodology
This is the operating manual Transgenia uses to implement Claude.ai inside a Mexican B2B distributor. It is not marketing, and it is not a promise of "digital transformation." It is the exact sequence of decisions we execute, over 5 phases and 30 days, so that by day 30 the client has enough evidence to scale, adjust, or discard the use case without guessing.
The manual is born from our own path as a registered Claude partner (Anthropic). Along that path our team completed the Delivery Methodology course of the Partner Badge · Claude Code, and with that training we generalized Anthropic's discipline (originally designed for software engineering pilots) to the real terrain of a distributor: international purchases, exchange rates, inventory, customs documents, and that margin that erodes before the sale even happens.
Two rules govern this manual and everything derived from it. First: no fabricated client numbers; when we illustrate with a figure, the public source is cited, or it is left as a diagnostic question for the client's real use case. Second: precise positioning. Transgenia is a registered Claude partner building toward full certification, with real deployment evidence. Not a certified partner (the final evaluation of the path is still pending). Not a candidate (that framing was left behind in August 2026). Both rules exist to protect the reader from the overselling that dominates the market.
Who this manual is for
This manual is written for three roles inside a B2B distributor:
- Operations Director or CEO: the person who approves the pilot and signs off on the success criteria.
- Owner of the candidate process (buyer, warehouse manager, cost analyst): the person who lives the process every day and will be the pilot cohort.
- IT or internal project sponsor: the person who coordinates access, baseline, and the link with Transgenia.
If your distributor is already evaluating "doing something with AI" but is still unclear on which process to measure first, with which baseline, and who owns adoption surviving week 3, this manual answers that.
1. Why a partner if Claude's AI already does everything?
It is the most honest question of any first meeting, and Anthropic does not dodge it: it appears explicitly in the introduction of the Partner Basecamp. They put it like this: "if models are commodities anyone can access, why bring in a partner when anyone can call the same APIs?" The answer also comes from the same material, and it is the one we apply here.
The bottleneck moved. When models were below the threshold, the hard question was "can the AI do this?" That question is already solved in most cases. Today's hard question is everything around the model: how you design the product on top of it, how you connect it to real data, how you measure quality, how you make people actually change the way they work. Anthropic says it without rhetoric: "the model is a commodity; the application layer is the product."
See Mermaid diagram

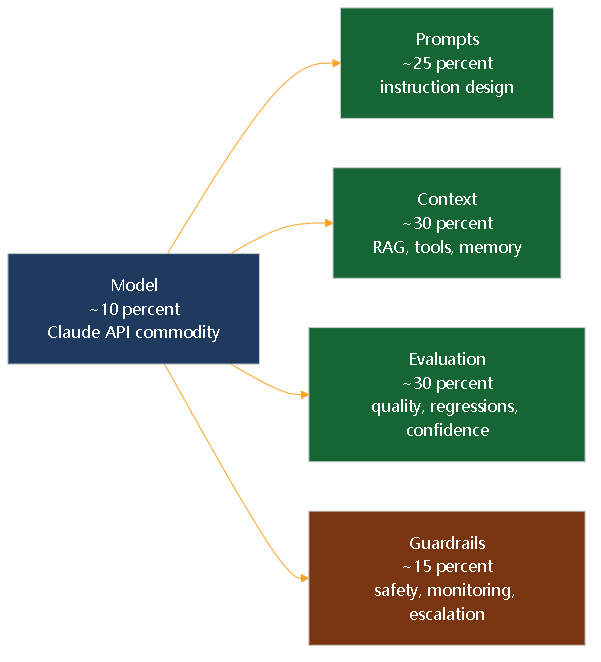

flowchart LR
M["Model
~10 percent
Claude API commodity"]
P["Prompts
~25 percent
instruction design"]
C["Context
~30 percent
RAG, tools, memory"]
E["Evaluation
~30 percent
quality, regressions, confidence"]
G["Guardrails
~15 percent
safety, monitoring, escalation"]
M --> P
M --> C
M --> E
M --> G
style M fill:#1e3a5f,color:#fff
style P fill:#166534,color:#fff
style C fill:#166534,color:#fff
style E fill:#166534,color:#fff
style G fill:#78350f,color:#fff
A partner who has already operated that 90 percent contributes four things the API by itself cannot: business context (knows which process qualifies for a pilot and which does not), application-layer design (prompts, RAG, evaluation and guardrails, not just the model call), honest measurement with a baseline (so that "after" is comparable to "before"), and change management (so that adoption survives week 3). Without those four, an AI pilot is an expensive toy. With those four, it is a decision with evidence on day 30.
This manual documents exactly those four layers.
2. Why most AI pilots don't reach day 30
The pattern repeats almost identically across sectors: a use case is chosen without qualifying it, launched without a documented baseline, no one is left internally accountable for the new process, and within weeks the pilot is silently abandoned. The failure is almost never the model. It is the absence of a methodology that pins down, before day 1, what will be measured, with which baseline, and who is accountable for adoption.
See Mermaid diagram

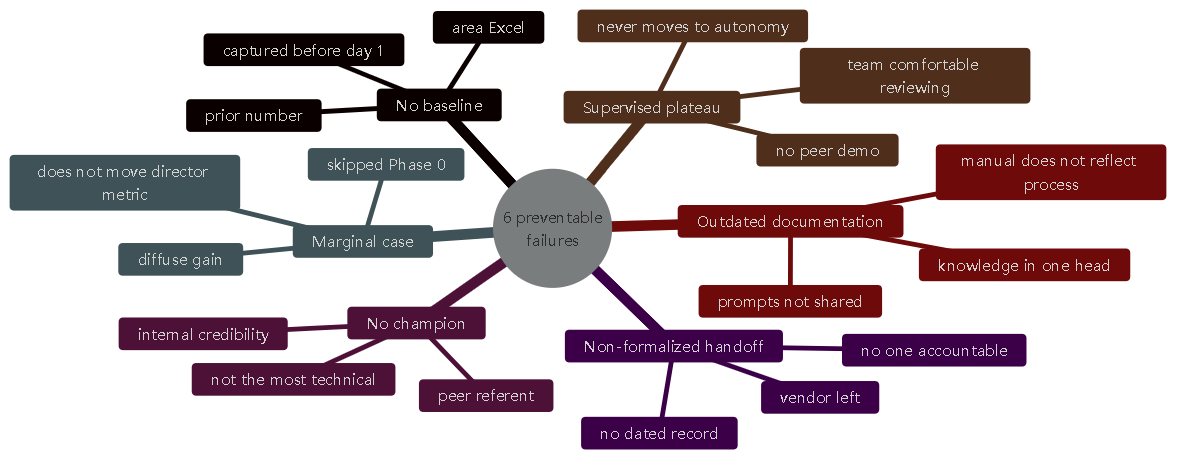

mindmap root((6 preventable
failures)) No baseline prior number area Excel captured before day 1 No champion peer referent not the most technical internal credibility Marginal case diffuse gain does not move director metric skipped Phase 0 Supervised plateau team comfortable reviewing never moves to autonomy no peer demo Outdated documentation manual does not reflect process prompts not shared knowledge in one head Non-formalized handoff vendor left no one accountable no dated record
Each of the 6 failures has an antibody in the phases that follow. It is not philosophy, it is a checklist.
3. The 5 phases · overview
See Mermaid diagram
flowchart LR
F0["Phase 0
Qualification
days 1-3"]
F1["Phase 1
Pilot design
days 1-3"]
F2["Phase 2
Measurement and ROI
days 4-30"]
F3["Phase 3
Staged adoption
days 4-27"]
F4["Phase 4
Closure and handoff
days 28-30"]
F0 --> F1 --> F2 --> F3 --> F4
style F0 fill:#166534,color:#fff
style F1 fill:#166534,color:#fff
style F2 fill:#1e3a5f,color:#fff
style F3 fill:#1e3a5f,color:#fff
style F4 fill:#78350f,color:#fff
Each phase has a verifiable exit condition. Without that condition, we do not advance. This gate discipline is what separates a pilot that produces a decision on day 30 from a demo that gets forgotten.
4. Phase 0 · Use case qualification
Not every process that "could use AI" deserves a pilot. The first decision is to distinguish between a marginal gain (saves time but does not change the business outcome) and a structural gain (moves a metric a director is already watching: margin per SKU, cash cycle, stockouts, dispatch time).
See Mermaid diagram

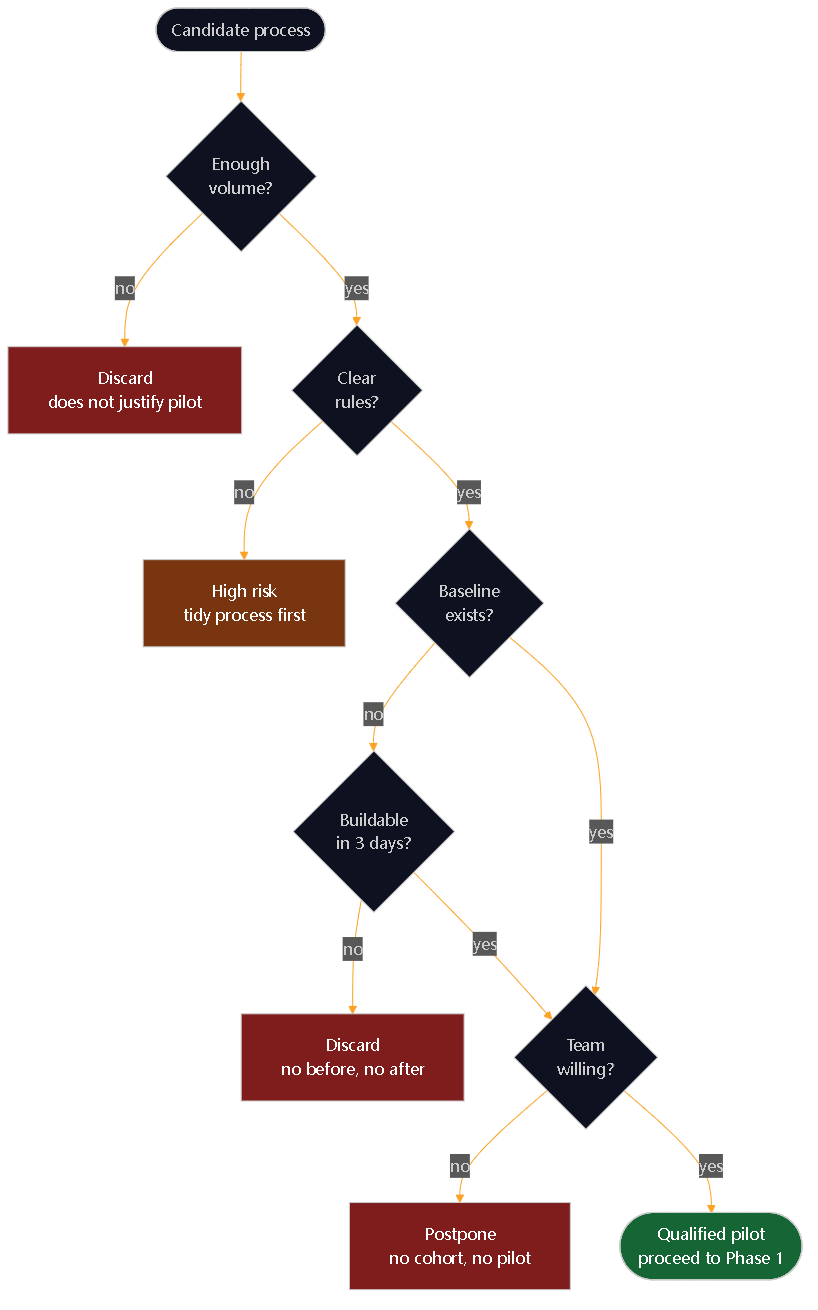

flowchart TD
Start(["Candidate process"]) --> Q1{"Enough
volume?"}
Q1 -- "no" --> Rej1["Discard
does not justify pilot"]
Q1 -- "yes" --> Q2{"Clear
rules?"}
Q2 -- "no" --> Risk["High risk
tidy process first"]
Q2 -- "yes" --> Q3{"Baseline
exists?"}
Q3 -- "no" --> Q3b{"Buildable
in 3 days?"}
Q3b -- "no" --> Rej2["Discard
no before, no after"]
Q3b -- "yes" --> Q4
Q3 -- "yes" --> Q4{"Team
willing?"}
Q4 -- "no" --> Rej3["Postpone
no cohort, no pilot"]
Q4 -- "yes" --> OK(["Qualified pilot
proceed to Phase 1"])
style OK fill:#166534,color:#fff
style Rej1 fill:#7f1d1d,color:#fff
style Rej2 fill:#7f1d1d,color:#fff
style Rej3 fill:#7f1d1d,color:#fff
style Risk fill:#78350f,color:#fff
The 4 filters, in order:
- Volume. Does it happen often enough that automating it matters? A process that happens once a quarter does not justify a 30-day pilot.
- Complexity. Does it have clear, repeatable rules, or does it depend on case-by-case undocumented judgment? High complexity without clear rules is a risk signal, not a pilot signal.
- Measurement. Does a baseline exist today, even in Excel, or would we have to invent one? If you cannot measure the "before," you cannot prove the "after."
- Team willingness. Is the person who lives the process willing to change their flow for 30 days? An enthusiastic volunteer outside the process validates that the tool is interesting, not that the real process improves.
Discard rule: high complexity plus non-existent measurement equals risk, not pilot. Postpone until the process is tidied up, or narrow the scope.
Use cases we have already qualified as structural in B2B distribution:
- Real landed-cost per SKU (freight, tariff, exchange rate, port handling, customs broker fees) instead of average costing that hides negative margins.
- International supplier follow-up agent and PO ETA, with reading of emails and attachments.
- Predictive inventory to reduce stockouts and free capital immobilized in slow-moving stock.
- Automatic reading and classification of customs documents (commercial invoices, pedimentos, packing lists, certificates of origin).
In each case, the metric that moves (margin per SKU, dispatch time, immobilized capital, capture errors) is a metric an operations director already watches. It is not a metric invented to justify the pilot.
5. Phase 1 · Pilot design
Once the use case is qualified, the pilot is designed with three non-negotiable decisions: the cohort, the operating scope, and the success criteria.
The cohort. It is whoever lives the process every day (the buyer, the warehouse manager, the cost analyst). Never an "enthusiastic volunteer" outside of it. An enthusiastic volunteer validates that the tool is interesting; we need to validate that the real process improves.
See Mermaid diagram

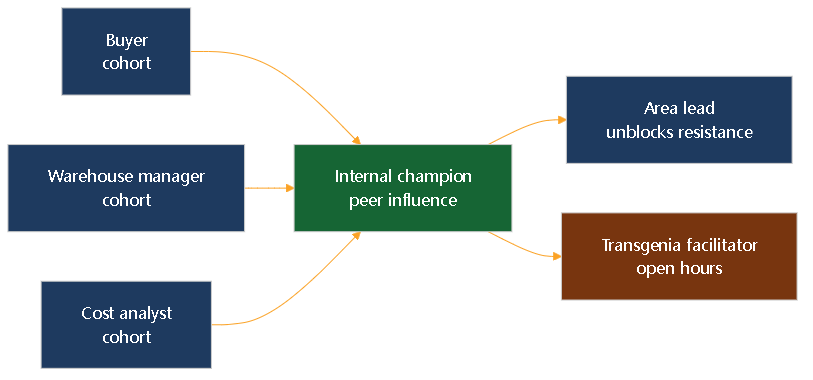

flowchart LR
C1["Buyer
cohort"]
C2["Warehouse manager
cohort"]
C3["Cost analyst
cohort"]
Champ["Internal champion
peer influence"]
Lead["Area lead
unblocks resistance"]
TGN["Transgenia facilitator
open hours"]
C1 --> Champ
C2 --> Champ
C3 --> Champ
Champ --> Lead
Champ --> TGN
style C1 fill:#1e3a5f,color:#fff
style C2 fill:#1e3a5f,color:#fff
style C3 fill:#1e3a5f,color:#fff
style Champ fill:#166534,color:#fff
style Lead fill:#1e3a5f,color:#fff
style TGN fill:#78350f,color:#fff
The scope. It is defined in precise operating terms, not aspirational ones. Not "digitize purchasing", but "automatic follow-up of the document status of international purchase orders, from supplier confirmation to warehouse receipt". The rule is that an outside reader can say without ambiguity "this is in the pilot, this is not".
Standard duration is two full cycles of the task being tested. For a distributor this is usually 25 to 30 days, enough to capture real variation: a typical purchase order, a month-end close, a high-volume week.
Success criteria are set before day 1, never after, with four explicit components:
- Baseline: today's number, documented with source and date.
- Threshold: what change would count as success.
- Method: how it will be measured (which report, which field, who captures it).
- Date: when the result is evaluated.
Setting this after seeing the first results invalidates the entire measurement. It is the most uncomfortable rule in the manual, and the one that has saved the most pilots.
6. Phase 2 · Measurement and evidence (ROI)
The baseline is captured before kickoff. A "reconstructed" baseline after two weeks of piloting is already contaminated by the very change we are trying to measure.
We measure in four categories, adapted from software engineering in Anthropic's original course to real business operations:

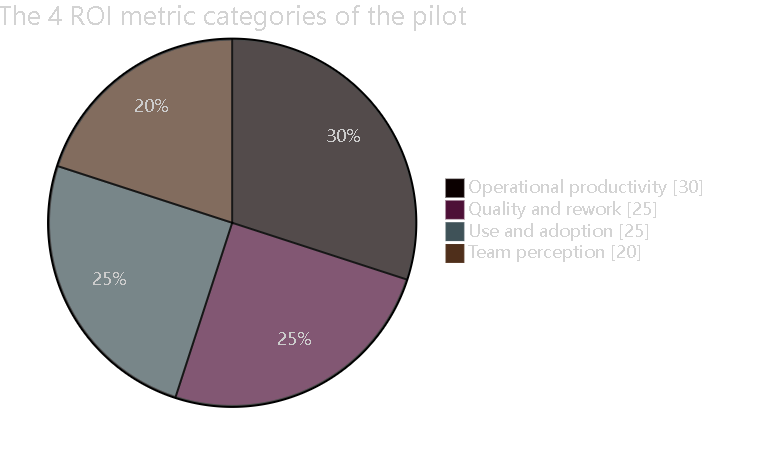

See Mermaid diagram
pie showData
title The 4 ROI metric categories of the pilot
"Operational productivity" : 30
"Quality and rework" : 25
"Use and adoption" : 25
"Team perception" : 20
- Operational productivity: person-hours per purchase order, per ETA reconciliation, per margin report.
- Quality and rework: capture errors, returns, cost discrepancies, orders that need to be reopened.
- Use and adoption: percentage of orders or documents that go through the AI flow versus the manual flow.
- Team perception: would the person who lives the process keep using it without being asked? This question is asked, verbatim, at the end.
The pilot result is reported as a number, with its translation into executive language, not as a list of technical observations. A sentence of the form "we went from X to Y person-hours per week in ETA reconciliation" is understood in the director's room. A sentence of the form "the agent correctly processes Z percent of supplier emails" is not, on its own. (X, Y, Z are format placeholders: each client closes their pilot with their own documented number.)
7. Phase 3 · Staged adoption
Real adoption follows a curve, not a switch. It goes from full review to autonomy across four stretches, and the dominant risk is not the initial drop: it is the plateau.
See Mermaid diagram
flowchart LR
S1["Week 1
Supervised
autonomy ~20 percent
calibration"]
S2["Weeks 2-3
Growing autonomy
~55 → ~80 percent
exception review"]
S3["Week 4
Agent mode
~95 percent
process runs itself"]
S4["Day 30+
Institutionalized
~100 percent
this is how we do it now"]
S1 --> S2 --> S3 --> S4
Plateau["Dominant risk:
supervised plateau"]
Plateau -.-> S2
style S1 fill:#7f1d1d,color:#fff
style S2 fill:#78350f,color:#fff
style S3 fill:#1e3a5f,color:#fff
style S4 fill:#166534,color:#fff
style Plateau fill:#101820,color:#FBA225,stroke:#FBA225
Week 1, supervised: the team reviews every agent output before using it. It is normal for velocity to drop this week. It is calibration, not failure.
Weeks 2-3, growing autonomy: the agent operates without review in already-validated cases; the team only reviews exceptions.
Weeks 3-4, agent mode: the process runs autonomously within the agreed scope, with exception reports.
Day 30 onward, institutionalized pattern: the AI-driven process is simply "how we do it now," documented and transferable to someone new in the role.
The most common risk is not the week-1 drop (expected). It is the plateau effect: the team settles into supervised mode and never advances. That effect is broken by a peer's demonstration who has already moved ahead, not by a vendor's motivational talk.
8. Phase 4 · Closure, champion and handoff
No pilot survives without an internal champion: the person who, inside the client team, becomes the reference for the new process. They are chosen by peer influence, not by being the most technical person on the team. The champion needs their peers to believe them, not to master the configuration.
A clean closure delivers, at minimum:
- Living process documentation (the client's internal
CLAUDE.md): what the agent does, what it does not, whom to escalate to when something falls outside scope. - Catalog of 3 to 5 reusable prompts or flows, already tested, that the team can run without depending on Transgenia for each variation.
- Checklist of the 6 preventable failures (Diagram 2), explicitly reviewed before declaring the pilot closed.
- Formal handoff record, with date, receiving owner, and the exact status of the process at the moment of handover.
Without a dated record and an accountable owner, the pilot is not closed. It is paused, waiting for someone to pick it up, which is exactly the "non-formalized handoff" pattern of Diagram 2.
9. 30-day operating rhythm
Five phases, each with a verifiable exit condition, and two scheduled touchpoints from day 1:
See Mermaid diagram

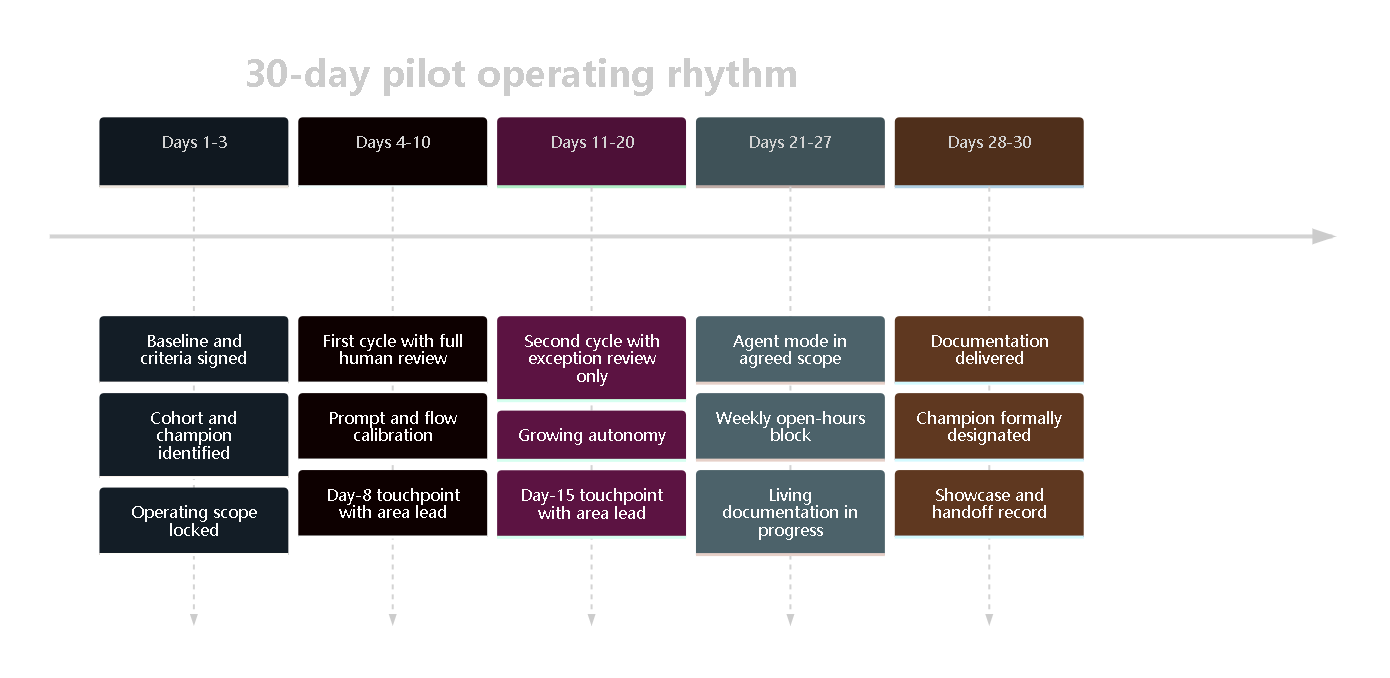

timeline
title 30-day pilot operating rhythm
Days 1-3 : Baseline and criteria signed
: Cohort and champion identified
: Operating scope locked
Days 4-10 : First cycle with full human review
: Prompt and flow calibration
: Day-8 touchpoint with area lead
Days 11-20 : Second cycle with exception review only
: Growing autonomy
: Day-15 touchpoint with area lead
Days 21-27 : Agent mode in agreed scope
: Weekly open-hours block
: Living documentation in progress
Days 28-30 : Documentation delivered
: Champion formally designated
: Showcase and handoff record
| Days | Phase | Exit condition |
|---|---|---|
| 1-3 | Qualification and baseline | Baseline documented and success criteria signed |
| 4-10 | Supervised pilot | First full cycle run with full human review |
| 11-20 | Growing autonomy | Second cycle run with exception-only review |
| 21-27 | Agent mode | Process running in scope without routine intervention |
| 28-30 | Closure and showcase | Documentation delivered, champion designated, record signed |
Touchpoints scheduled from day 1 (not reactive):
- Day 8 or 15, 30 minutes with the area lead, to unblock any resistance before it accumulates.
- Weekly open-hours block (60 min), which by the end of the pilot is facilitated by the internal champion, not Transgenia.
Day-30 showcase, in three 10-minute blocks: live demo of the process running, then before/after numbers, and finally an explicit conversation about continuity.
10. The day-30 decision
The manual is designed to produce a decision with evidence, not a report. At the closing showcase, the distributor walks out with one of three decisions:
See Mermaid diagram

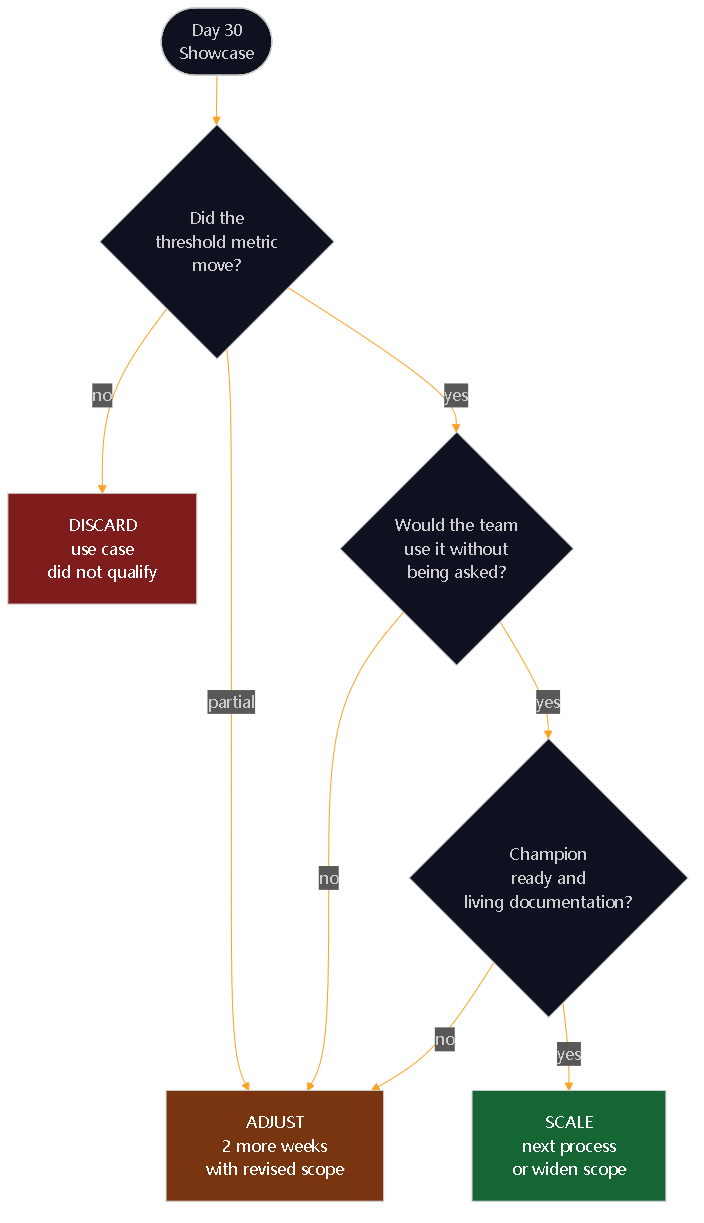

flowchart TD
Start(["Day 30
Showcase"]) --> Q1{"Did the
threshold metric
move?"}
Q1 -- "no" --> Discard["DISCARD
use case
did not qualify"]
Q1 -- "partial" --> Adjust["ADJUST
2 more weeks
with revised scope"]
Q1 -- "yes" --> Q2{"Would the team
use it without
being asked?"}
Q2 -- "no" --> Adjust
Q2 -- "yes" --> Q3{"Champion
ready and
living documentation?"}
Q3 -- "no" --> Adjust
Q3 -- "yes" --> Scale["SCALE
next process
or widen scope"]
style Scale fill:#166534,color:#fff
style Adjust fill:#78350f,color:#fff
style Discard fill:#7f1d1d,color:#fff
- Scale: the case moved the metric, the team adopted it, and the champion is ready. Next process or scope expansion.
- Adjust: there is movement but incomplete. Two more weeks with revised scope and recalibrated criteria.
- Discard: the case did not qualify. The learning is documented and the team is released. Discarding honestly on day 30 is a valid outcome, not a defeat.
11. Why this is also an asset for Transgenia
Every engagement executed with this methodology does not only deliver value to the client: it directly feeds Transgenia's status inside the Claude (Anthropic) Partner Program.
See Mermaid diagram
flowchart LR
T1["Registered
minimum commitment:
10 certified
individuals"]
T2["Select
10 active individuals
2 clients in production
1 public story"]
T3["Elite
extended criteria
Anthropic-referred"]
T1 --> T2 --> T3
Today["Transgenia today:
Registered
building evidence"]
Today -.-> T1
style T1 fill:#166534,color:#fff
style T2 fill:#1e3a5f,color:#fff
style T3 fill:#78350f,color:#fff
style Today fill:#101820,color:#FBA225,stroke:#FBA225
Anthropic's Partner Program Guide · Services Edition measures three dimensions without averaging (being strong in only one is not enough): certified individuals on the team, joint clients deployed in production, and publishable client stories. Every engagement executed with this manual is, at the same time, evidence toward those three dimensions.
The current and honest formulation, the same one we use with clients: Transgenia is a registered Claude partner building toward full certification, with real deployment evidence. Not a certified partner, not a candidate. The distinction matters because the market is full of providers hanging off the Anthropic logo without being able to show the path.
